Risk Register: What It Is and How to Build One (Template)

Turn this article into takeaways for your work.
Each assistant summarizes the article only for you and suggests best practices for your work.
A risk register is the document that turns vague project anxiety into a structured, manageable list. Every project has risks. The question is whether those risks live in someone's head or in a shared document the whole team can act on.
What is a risk register?
A risk register is a project management tool that records identified risks, their probability and impact scores, assigned owners, and planned response strategies in a single shared document. It's sometimes called a risk log, though the two terms are essentially interchangeable in practice.
The register doesn't eliminate risk. It makes risk visible, so your team can decide which risks to mitigate, which to monitor, and which to simply accept. A risk you've documented is a risk you can manage. A risk that lives only in someone's memory is a deadline waiting to blow up.
Key Facts
- Projects with active risk management practices are 2.5 times more likely to meet their goals than those without them (PMI Pulse of the Profession, 2023).
- Poor risk management is the second most common cause of project failure, cited by 39% of project professionals globally (PMI, 2024).
- Organizations that manage risks proactively waste 13 times less money than those that don't (PMI Pulse of the Profession, 2023).
What goes in a risk register (the columns)
A risk register works best when every column has a clear purpose. Here are the standard fields and what each one does.

| Column | Purpose | Example |
|---|---|---|
| Risk ID | Unique identifier for referencing the risk in meetings and reports | R-001, R-002 |
| Description | Plain-language statement of what the risk is and why it matters | "Key offshore contractor may not be available after August due to visa renewal delays" |
| Category | The type of risk: Technical, Resource, Schedule, Budget, External, Compliance | Resource |
| Probability | Likelihood of the risk occurring: Low / Medium / High (or 1-5 scale) | High |
| Impact | Severity if the risk occurs: Low / Medium / High (or 1-5 scale) | High |
| Risk Score | Probability multiplied by impact, used for prioritization | 9 (3x3) |
| Owner | The named individual responsible for monitoring and responding to this risk | Alex Kim |
| Response Strategy | How the team plans to handle it: Avoid, Mitigate, Transfer, Accept | Mitigate: identify backup contractor by July |
| Status | Current state of the risk: Open, In Progress, Closed, Accepted | Open |

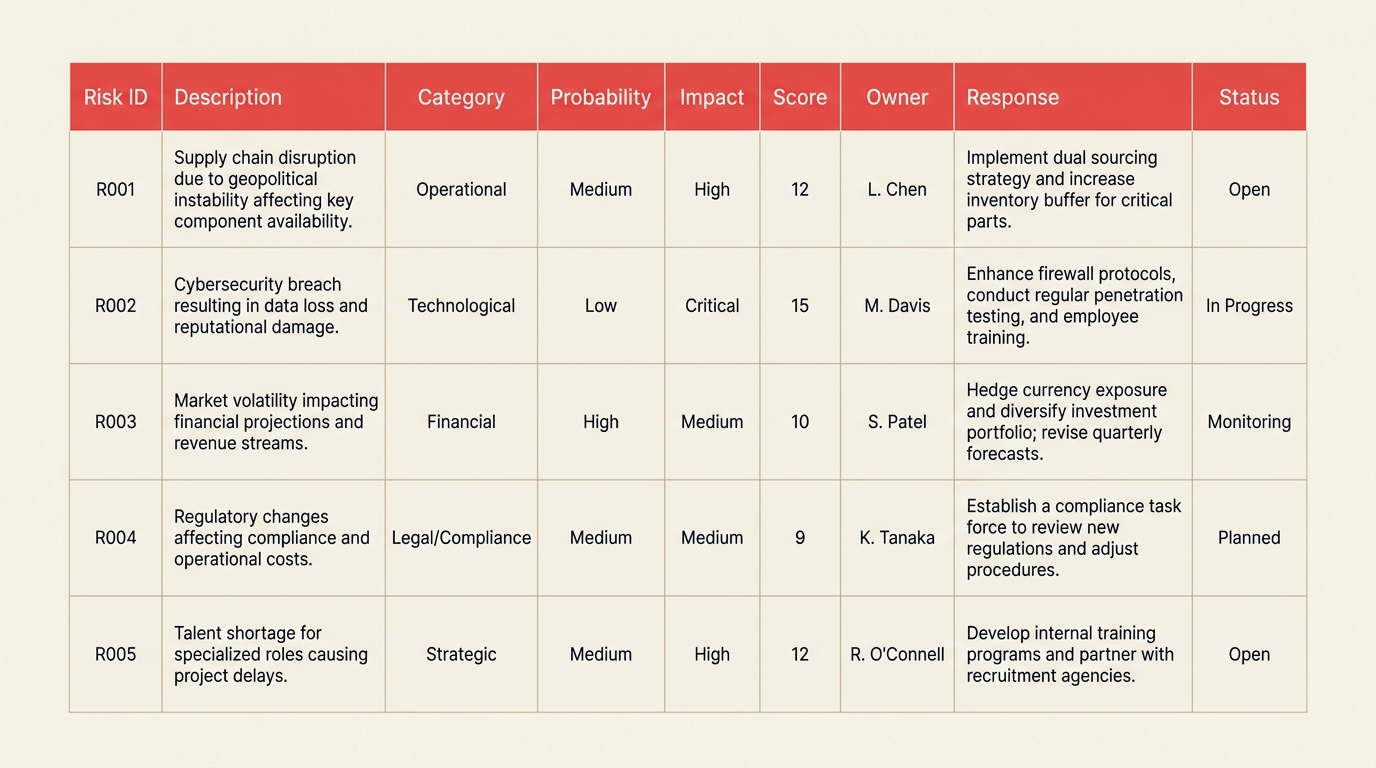

Here's what a populated risk register looks like with a few realistic rows:
| Risk ID | Description | Category | Probability | Impact | Score | Owner | Response | Status |
|---|---|---|---|---|---|---|---|---|
| R-001 | Vendor hardware delivery delayed due to supply chain disruption | External | High | High | 9 | Alex Kim | Source backup vendor; weekly check-ins with primary | Open |
| R-002 | Budget increase if exchange rates shift more than 8% | Financial | Medium | Medium | 4 | Priya Sharma | Lock annual contract pricing before Q3 | Open |
| R-003 | Key developer resigns before feature freeze | Resource | Low | High | 3 | Jamie Lee | Cross-train second developer on critical modules | Accepted |
| R-004 | Regulatory approval delayed beyond planned go-live | Compliance | Medium | High | 6 | Sam Torres | Submit compliance package 6 weeks early | In Progress |
| R-005 | Integration testing environment not available on schedule | Technical | High | Medium | 6 | Morgan Reyes | Reserve backup environment; escalate to IT lead | Open |
The Risk Score column is your prioritization engine. Risks scored at 6 or higher typically land on your weekly agenda. Risks scored at 3 or below can move to a watch list unless something changes.
Risk register vs risk log vs RAID log
These terms overlap more than they should, which creates real confusion in project teams. Here's a clear comparison.

| Risk Register | Risk Log | RAID Log | |
|---|---|---|---|
| Scope | Risks only | Risks only | Risks, Assumptions, Issues, Dependencies |
| Depth | Deep: probability, impact, score, response plan | Moderate: tracks status and owner | Moderate: one document across four categories |
| Best for | Large programs, regulated industries, high-stakes projects | Lightweight tracking for smaller projects | Most project teams; broad coverage in one place |
| Update cadence | Monthly or event-driven | Weekly | Weekly in status meetings |
In practice, "risk register" and "risk log" are used interchangeably in most teams. The meaningful distinction is between a standalone risk register (risks only, with full depth) and a RAID log, which covers risks alongside assumptions, issues, and dependencies in a single document at moderate depth.
For most project managers, the RAID log is the right starting point. The risk register makes sense when your project is large enough, or regulated enough, that the risk category alone needs its own dedicated document with full probability-impact analysis.
Benefits of a risk register
It surfaces risks before they become crises. The process of building a risk register forces the team to think through what could go wrong before anything actually does. Teams that run through this exercise at project kickoff catch problems weeks or months earlier than teams that don't.
It creates a shared language for uncertainty. When everyone on the team can point to the same risk register, "I'm worried about the vendor timeline" becomes "R-001 is rated High/High and Alex owns the mitigation." That precision changes how conversations go in status meetings.
It gives the project manager something to show. When a sponsor asks why a delivery date slipped, the risk register shows whether the event was logged, who owned it, and whether the mitigation plan was followed. That's not just defensive. It's how project teams build credibility over time.
It connects risk to the work breakdown structure. Once risks are documented, you can trace which workstreams carry the most exposure. That informs how you allocate buffer in your schedule and where you assign your strongest people.
It feeds better stakeholder analysis. Knowing which risks affect which stakeholders helps you decide who needs to be informed, who needs to be consulted, and who has the authority to approve a response plan.
Common mistakes
Logging risks once and never reviewing them. A risk register that isn't reviewed regularly becomes fiction. Risks change status. New risks emerge. Owners leave. Schedule a fixed slot in your weekly status meeting for a 10-minute risk review, or the document will drift.
Using vague descriptions. "Communication risk" is not a risk. "Client stakeholders have not confirmed sign-off on the scope document, and the project can't move to the build phase without it" is a risk. Be specific enough that someone who wasn't in the room when the risk was logged understands exactly what's at stake.
Assigning risks to teams instead of people. "The IT team" is not an owner. One named person is the owner. That person monitors the risk, escalates if needed, and updates the status at each review. A team can't be held accountable. A person can.
Rating everything as High. When every risk is a 9, nothing is a 9. Calibrate your scores honestly. A well-rated register lets you focus energy on the risks that actually matter. A register full of 9s creates noise and burns attention on things that don't warrant it.
Treating the register as a compliance artifact. Some project managers build a risk register because the project governance framework requires one, then never open it again. A risk register only earns its keep if it's a live document in active use.
Forgetting to close resolved risks. When a risk is mitigated or avoided, close it with a note on what happened. Those closed entries become institutional knowledge for the next similar project.
How to build a risk register
Building the register is a sequence: surface the risks first, score them consistently, then assign ownership and response plans.

Step 1: Identify the risks
Start at project kickoff. Run a structured brainstorm with your core team: what could go wrong? What are we assuming that might not hold? What are we depending on from external teams or vendors? Pull in lessons-learned documents from similar past projects. The goal is to surface as many risks as possible before you start ranking them. Quantity before quality at this stage.
Common categories to prompt the discussion: technical risks, resource risks, schedule risks, budget risks, external dependencies, compliance and regulatory risks, and stakeholder risks.
Step 2: Write clear, specific descriptions
For each risk, write a one-to-two sentence description that explains what the risk is and why it matters to the project. Avoid shorthand. "API integration failure" is less useful than "Third-party payment API may not support our authentication protocol, requiring a custom middleware build that adds four to six weeks to the schedule."
Step 3: Score probability and impact

Use a consistent scale across the whole register. A 3-point scale (Low, Medium, High mapped to 1, 2, 3) works for most teams. A 5-point scale works for large programs. Don't mix scales within the same register.
Score probability based on how likely the risk is to occur given everything you know about the project context, the team, the vendor history, and the market. Score impact based on how bad the outcome would be if the risk materialized. Then multiply: a Medium probability (2) combined with High impact (3) gives a score of 6.
Step 4: Prioritize by score and assign owners
Sort your risk register by score, highest to lowest. Risks at 6 or above get active mitigation plans and weekly review. Risks at 3 to 4 go on the watch list and get reviewed monthly. Risks at 1 to 2 are accepted: you note them but don't allocate mitigation resources.
For every risk at 4 or above, assign a named owner. That person is responsible for monitoring the risk, executing the response plan, and flagging any change in status. Cross-reference with your RACI matrix to make sure the owner assignment is consistent with project accountability roles.
Step 5: Define response strategies
Each risk needs a documented response. There are four standard types:
- Avoid: Change the project plan to eliminate the risk entirely. Example: if a vendor has a poor track record, switch vendors before the risk can materialize.
- Mitigate: Take action to reduce the probability or impact. Example: cross-train a second developer to reduce the impact of a key-person risk.
- Transfer: Shift the risk to a third party. Example: purchase project insurance or add a performance clause to a vendor contract.
- Accept: Acknowledge the risk and prepare a contingency plan, but don't take proactive action. Best for low-score risks where mitigation costs more than the potential impact.
Step 6: Review and monitor throughout the project
The risk register is not a kickoff artifact. It's a living document. Review it weekly in your status meeting: update statuses, confirm response plans are being executed, close resolved risks, and add new ones as they emerge. During high-risk phases of the project life cycle, consider a mid-week risk check for any High-rated open items.
When a risk materializes, it becomes an issue and should be tracked accordingly. In a RAID log, you'd move it from the Risk section to the Issue section. In a standalone risk register, change the status to "Realized" and open a separate issue log entry.
Risk register examples by project type
Different project types carry different risk profiles. Here's how a risk register entry looks across three common contexts.

| Project Type | Example Risk | Category | Probability | Impact | Response Strategy |
|---|---|---|---|---|---|
| Software launch | Cloud hosting provider changes API rate limits before go-live | Technical | Medium | High | Build abstraction layer; test with rate-limit simulation in staging |
| Construction | Subcontractor fails to meet safety certification before site access | Compliance | Low | High | Require certification proof 30 days before site start; identify backup sub |
| Marketing campaign | Creative agency delivers final assets one week late, compressing paid media ramp-up | Schedule | High | Medium | Add creative delivery milestone two weeks before campaign launch; get partial assets early |
For a software project, technical and resource risks tend to dominate. For construction, regulatory compliance and weather-related schedule risks carry the most weight. For marketing launches, vendor and creative delivery timelines are the biggest exposure. The structure of the register stays the same across all three. The categories and scores just shift.
If your project involves multiple workstreams, consider linking your risk register to the critical path method analysis. Risks that affect critical path tasks deserve higher priority than risks that affect float tasks, even at the same probability-impact score.
Best practices
Do assign one named owner per risk. Not a team. Not a role. A person.
Do review the register in every status meeting. Even a 10-minute pass is enough to keep it current and credible.
Do connect high-scoring risks to your project scope statement. If a risk threatens core deliverables, that's a sponsor conversation, not just a PM note.
Do close risks with a written note. When a risk is resolved or avoided, document what happened. Future teams on similar projects will use those closed entries.
Don't let the register grow without pruning. A register with 80 open risks is unusable. Close accepted risks, archive resolved ones, and keep the active list focused on what the team can actually act on.
Don't use color alone to signal severity. Some team members are color-blind, and exports often lose formatting. Use text labels (Low, Medium, High) alongside any color coding so the information survives format changes.
The best risk registers are simple enough to actually use and detailed enough to actually matter. Start with the nine columns above, score your risks honestly, assign real owners, and review the document every week. Do that consistently, and the register becomes one of the most valuable conversations your team has throughout the project.
